Introduction
Starting a commercial kitchen represents one of the largest financial commitments a food service business will ever make — and the majority of first-time operators significantly underestimate what they'll actually spend. According to the National Restaurant Association, 42% of operators reported being unprofitable in 2025, with cash flow problems driving 82% of business failures across the industry.
Much of that failure traces back to one root cause: the gap between projected and actual startup costs. Underestimate early, and you run out of runway before the business can find its footing.
It doesn't matter if you're launching a ghost kitchen or building a full-service restaurant from scratch — understanding the complete financial picture is what separates sustainable growth from early closure.
This guide covers startup cost ranges by kitchen type, the factors that move numbers up or down, and a practical framework for building an accurate budget for your concept.
TL;DR
- Commercial kitchen startup costs range from $20,000–$60,000 for ghost kitchens to $375,000–$2M+ for full-service restaurant builds
- The biggest cost drivers are kitchen size, equipment quality, location, and build-out scope
- Operational costs (utilities, labor, permits) compound monthly — budget for them before you open
- Most operators underestimate hidden costs: pre-opening rent, utility deposits, and working capital reserves
How Much Does a Commercial Kitchen Cost?
Commercial kitchen startup costs don't have a fixed price tag. They vary dramatically based on kitchen type, scale, location, and whether you're leasing a turnkey space, renovating an existing facility, or building from scratch. What often goes wrong is relying on rough estimates — operators underbudget for permits, choose equipment that doesn't fit their workflow, and hit surprise expenses only after signing the lease.

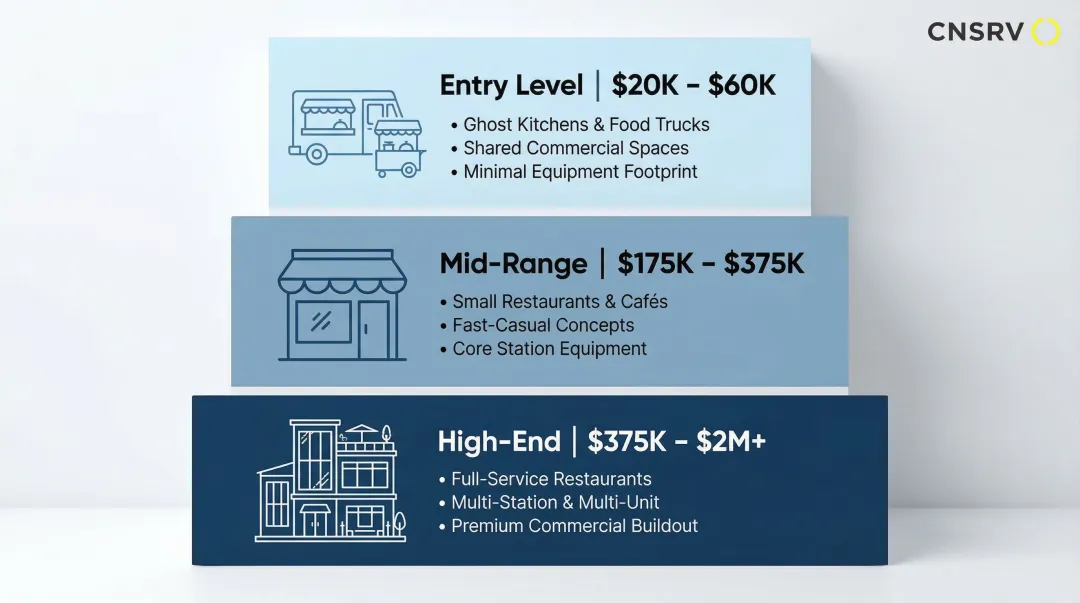

Startup Cost Ranges by Kitchen Type
Entry-Level Setup: $20,000–$60,000
Ghost kitchens, shared commercial kitchens, and food truck operations fall into this tier. Startup costs typically range from $20,000 to $60,000, with access to existing equipment, basic licensing, and shared infrastructure already in place.
This route suits early-stage entrepreneurs testing concepts, single-product businesses, small caterers, and delivery-only brands that need speed to market without a large upfront investment. Expect to pay $20–$65 per hour or $1,500–$4,000 monthly for rental fees, plus storage costs.
Mid-Range Setup: $175,000–$375,000
Small to mid-size restaurant kitchens, cafés with full prep areas, and fast-casual operations typically fall here. A mid-range build-out generally includes:
- Leased space renovation sized to your service model
- New or certified-used commercial equipment matched to your menu
- Full permitting packages and health department inspections
- Fixed location that supports both dine-in and delivery
Operators launching a permanent location with moderate volume benefit most from this approach. You're designing the space around your specific workflow rather than adapting to whatever a shared kitchen offers.
Once your concept is proven and volume demands it, build costs scale accordingly.
High-End Setup: $375,000–$2M+
Full-service restaurants, multi-station kitchens, and high-volume or multi-unit operations require this level of investment. Costs can exceed $2 million depending on location and scale.
Several factors push costs into this range:
- Premium equipment packages with extended warranties
- Custom kitchen design and workflow engineering
- Advanced HVAC and fire suppression systems
- Extensive permitting, inspections, and code compliance
- Architectural fees for complex or multi-station builds
This tier fits established operators with proven concepts, investors backing destination dining, or multi-unit franchises scaling a format.

Key Factors That Affect Your Commercial Kitchen Startup Costs
The same kitchen concept can cost vastly different amounts depending on a handful of operational and logistical decisions. Understanding these factors helps you control costs without cutting corners on functionality.
Location and Real Estate
Location affects both rental or purchase cost per square foot and the cost of permits and inspections. Urban markets dramatically inflate total startup costs compared to rural or suburban locations.
Retail rents in "Live-Work-Play" districts show massive regional disparity:
- New York City: $91.40 per sq. ft.
- Boston: $47.33 per sq. ft.
- Washington, D.C.: $46.21 per sq. ft.
- San Francisco: $27.80 per sq. ft.
Permitting costs vary by 30x depending on the market. First-year regulatory costs for food trucks average $17,066 in Boston compared to just $590 in Indianapolis.
Kitchen Size and Layout Design
A larger kitchen requires more equipment, more ventilation, more electrical and plumbing capacity, and more labor to install and maintain. But size alone doesn't determine cost — layout efficiency matters just as much.
A poorly optimized layout wastes space and drives up costs. Hiring a professional kitchen designer adds upfront cost — typically 5–15% of the construction budget — but prevents expensive reconfigurations later when workflow doesn't match equipment placement.
Equipment Quality and Sourcing Strategy
Commercial kitchen equipment represents one of the largest cost line items. Outfitting a commercial kitchen with new equipment typically ranges from $40,000 to $200,000, depending on menu complexity and volume.

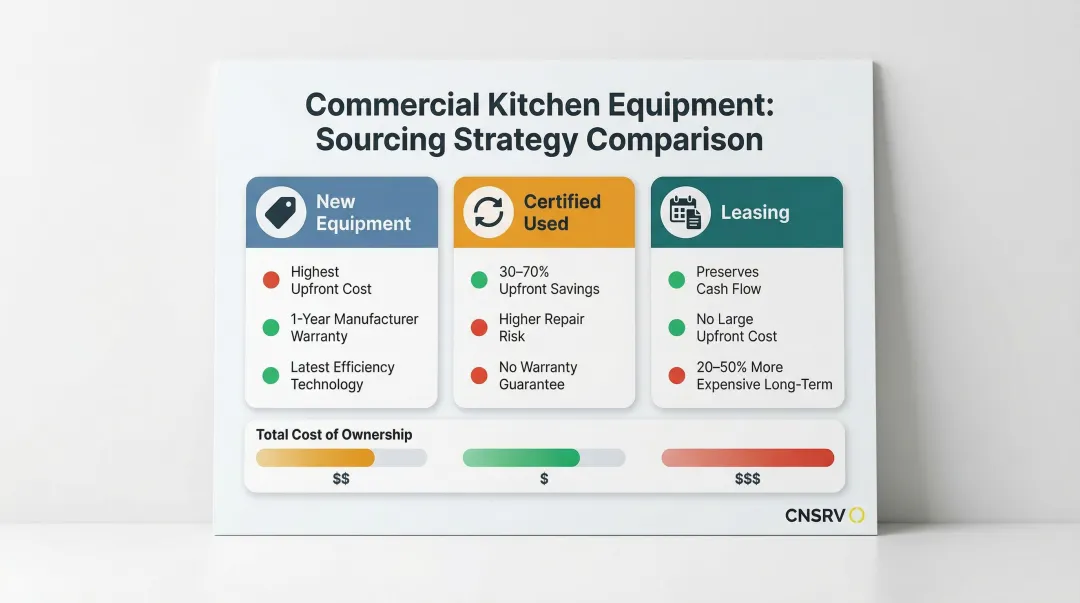

Your sourcing strategy shapes costs as much as the equipment itself:
- New equipment carries the highest upfront cost but includes warranties (typically 1 year parts/labor) and current efficiency technology
- Certified-used equipment saves 30–70% upfront but increases the risk of downtime and repair costs
- Leasing preserves cash flow but costs 20–50% more over the long term

Build-Out vs. Renovation vs. Turnkey Space
The cost difference between building from scratch, renovating existing space, and leasing turnkey facilities is substantial:
- New build from shell: $250–$400 per sq. ft. for build-out alone
- Renovation of second-generation space: $150–$300 per sq. ft., with 30–50% savings when existing hoods, walk-ins, and grease interceptors are already in place
- Turnkey or shared kitchen: lowest upfront cost, with existing infrastructure already in place
Structural work adds cost regardless of path — plumbing, gas lines, electrical panels, and fire suppression are required in most jurisdictions. Ventilation hoods alone run $15,000–$45,000, while fire suppression systems add another $2,000–$5,500.
Permits, Licenses, and Health Code Compliance
Permits and inspections are non-negotiable — and costs vary significantly by jurisdiction. Health permits, fire permits, zoning approvals, and food handler certifications all add to your pre-opening budget.
| City | Health Permit | Fire Permit | Notable Requirements |
|---|---|---|---|
| New York City | $280/year | $375 | Can open 22 days after applying |
| Los Angeles | $1,044–$2,723 | Varies | Sequential approvals required |
| Chicago | ~$330 + $600 environmental fee | Varies | Team inspections available |
Some jurisdictions require multiple inspections before opening, each with associated fees. Delays in permitting add to soft costs like rent paid during pre-opening periods.
Complete Cost Breakdown: One-Time vs. Recurring Expenses
Total commercial kitchen cost goes far beyond equipment purchase price. You must fund both one-time startup costs and ongoing monthly expenses from the start.
One-Time Startup Costs
| Line Item | Typical Range | Notes |
|---|---|---|
| Lease Deposit | 3–6 months' rent | Higher if credit is weak or TI is high |
| Architect/Design | 5–15% of construction cost | Includes blueprints for permitting |
| Build-Out Labor | 50–60% of renovation budget | Skilled trades drive this cost |
| Equipment Package | $40,000–$200,000 | Varies by menu complexity |
| Initial Inventory | $5,000–$15,000 | Food, beverage, packaging |
| Smallwares | $3,000–$8,000 | Pots, pans, utensils, containers |
| Licenses/Permits | $1,000–$5,000+ | Excludes liquor licenses |
Recurring Operating Costs
Once open, your monthly burn rate determines survival.
| Cost Category | Monthly Benchmark | Notes |
|---|---|---|
| Rent | $3,000–$10,000 | Varies by market and region |
| Utilities | $2.90/sq. ft. (electric) | Demand charges can be 30–70% of bill |
| Staff Wages | Cooks median ~$17.19/hr | Labor typically ~30% of revenue |
| Food Cost | ~32% of sales | Median for full-service restaurants |
| POS/Software | $69–$399/month | Plus payment processing fees |
Water and energy costs are consistently underestimated at the planning stage — and equipment choices made during setup directly determine how high these bills run each month.
Water use is one area where operational habits drive costs more than most owners expect. Kitchens relying on running-faucet defrosting can consume up to 1,000,000 gallons annually, adding up to $20,000 per year in combined water and sewage fees. Switching to a closed-loop defrosting system — such as the NSF-listed CNSRV DC:02 — can cut that water use by 98%, meaningfully reducing monthly utility costs over time.
Maintenance and Repairs
Commercial kitchen equipment operates under heavy, continuous use and will require servicing. The National Restaurant Association recommends budgeting 1.5% of sales for maintenance.
Cheaper equipment typically breaks down more often. Budget for:
- Annual maintenance contracts with service providers
- Routine part replacements on high-use equipment
- Unexpected repairs during peak service periods
Equipment nearing 10 years old with escalating repair costs is often better replaced than continuously serviced.
Licensing Renewals and Compliance Costs
Renew permits and health certifications annually — missing these deadlines can trigger fines or temporary closures.
Budget for:
- Food handler recertification
- Fire safety inspection renewal
- Health permit annual fees
- State-level food manufacturing licenses
Budget vs. Premium Kitchen Setups — What's the Real Difference?
The gap between budget and premium commercial kitchens isn't just about aesthetics — it affects throughput, food safety, equipment lifespan, and long-term cost of ownership.

| Category | Budget Spec | Premium/ENERGY STAR Spec | Efficiency Impact |
|---|---|---|---|
| Convection Oven | Standard gas/electric | ENERGY STAR certified | Saves ~$1,500 lifetime; ~30% more efficient |
| Fryer | Standard | High-efficiency/infrared | Saves ~$4,000–$6,000 lifetime; faster recovery |
| Steamer | Boiler-based | Connectionless/boilerless | Saves up to 90% water; eliminates boiler maintenance |
| Refrigeration | Standard | ENERGY STAR | ~9–10% energy savings; better insulation |
Beyond the purchase price, the real gaps show up in four areas:
- Warranties and durability: Budget equipment typically carries 90-day to 1-year warranties. Premium units are built for higher-volume operations and break down less often — which matters when a down fryer kills your lunch service.
- Utility savings: ENERGY STAR equipment in high-intensity categories can cut utility bills by 10–70%. Those savings compound monthly, and the premium usually pays back within 2–3 years.
- Peak throughput: Faster recovery times and tighter temperature control affect how many covers you serve at peak — a gap that's invisible on a spec sheet but obvious on a Friday night.
- Compliance exposure: Budget equipment may not carry NSF or UL certification required by health and fire codes. A failed inspection means replacement costs before you're permitted to open.

Volume, menu complexity, and growth trajectory all shape which tier makes sense. A ghost kitchen running limited SKUs can extract solid ROI from mid-tier equipment. A full-service restaurant doing 200 covers a night usually can't afford the downtime that comes with budget specs.
How to Estimate the Right Commercial Kitchen Budget
A budget should be built around operational needs, not just what seems affordable upfront. Both underfunding and over-speccing carry real costs — one stalls operations, the other bleeds capital before you open.
Key Inputs for Realistic Budget Estimation:
- Expected daily covers or production volume — determines equipment capacity and kitchen size
- Menu complexity and equipment requirements — simple menus need fewer specialized tools
- Whether space is leased or owned — affects deposit requirements and build-out responsibility
- Local permit and utility cost benchmarks — varies by market
- Contingency buffer — industry experts recommend 10–20% above projected costs
Before finalizing any numbers, take these three steps:
- Get itemized quotes from at least three contractors and equipment suppliers
- Consult a kitchen designer or food service consultant to avoid over- or under-speccing the space
- Build a 12–15 month cash flow projection to determine working capital needs and how long you can operate before reaching profitability
What Most Kitchen Operators Miss in Their Budget

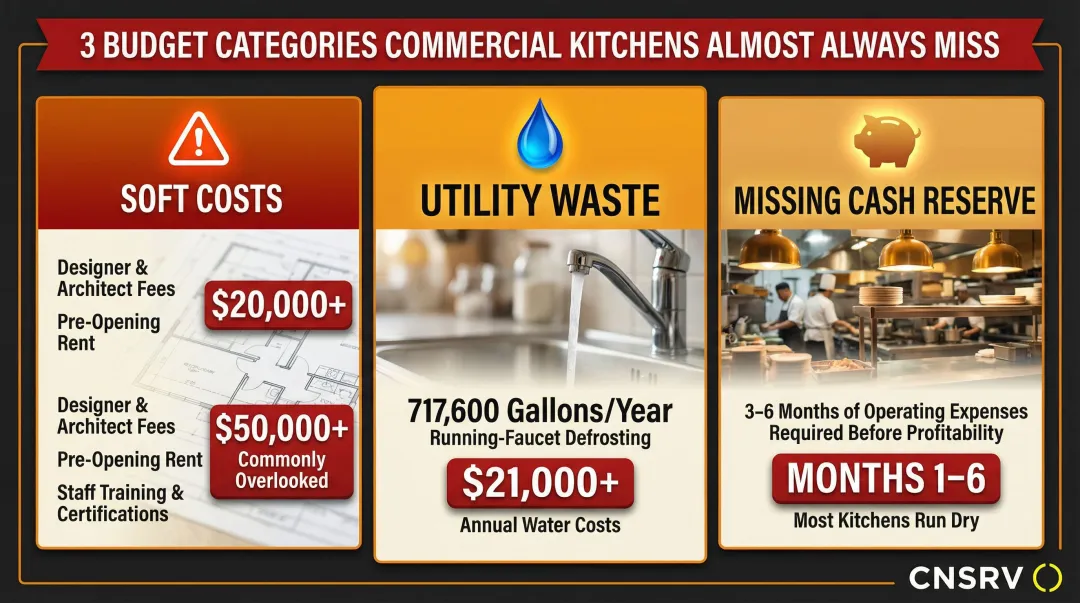

Soft Costs That Drain Early Capital
Most operators focus exclusively on equipment and build-out costs — ignoring the professional fees, pre-opening rent, and training expenses that quietly consume capital before the first service. These soft costs can add $20,000+ to your budget:
- Designer, lawyer, and accountant fees during the planning phase
- Pre-opening rent while permits are pending and build-out is underway
- Staff training costs before revenue starts coming in
Underestimating Recurring Utility Costs
Water and energy costs compound every month. Operators using water-intensive practices — such as running-faucet food defrosting — often face higher monthly bills than their projections assumed. A typical commercial kitchen using traditional defrosting methods can waste up to 717,600 gallons annually, resulting in over $21,000 in combined water and sewage costs. Those recurring monthly losses are exactly what makes a cash reserve non-negotiable.

Skipping a Financial Buffer
Working capital reserves for the first 3–6 months are non-negotiable, yet many operators underfund them. Lease deposits alone can require 3–6 months' rent upfront. Add payroll, inventory, and unexpected costs while revenue ramps up, and a single slow opening week or delayed permit can force closure before the kitchen ever hits its stride.
Frequently Asked Questions
How much does it cost to build a commercial kitchen from scratch?
A full commercial kitchen build-out typically ranges from $250 to $400 per square foot for construction alone. Total startup costs for a full-service restaurant often range from $375,000 to over $2 million depending on size, location, and required infrastructure like gas lines, HVAC, and fire suppression systems.
What is the biggest expense when setting up a commercial kitchen?
Commercial kitchen equipment typically represents the largest single cost category, ranging from $40,000 to $200,000, followed by space build-out and labor. Together, equipment and construction can account for 60–80% of total startup investment.
Is it cheaper to rent a commercial kitchen than build one?
Yes, significantly. Renting a shared or ghost kitchen dramatically reduces upfront costs, with startup costs typically $20,000 to $60,000 compared to hundreds of thousands for brick-and-mortar builds. However, it comes with limitations on hours, storage, customization, and ongoing rental fees of $20–$65 per hour.
What permits do I need to open a commercial kitchen, and how much do they cost?
Requirements vary by state and city but typically include health permits, fire permits, zoning approval, and food handler certifications. Costs vary widely — from $280 annually in New York City to over $2,700 in Los Angeles County.
What ongoing monthly costs should I plan for after opening?
Budget for rent ($3,000–$10,000/month), utilities ($2.90/sq. ft. for electric), labor (~30% of revenue), and food costs (~32% of sales). Utility costs fluctuate based on equipment efficiency and operational practices, so equipment choices made at startup directly affect your monthly overhead.
How much of a contingency budget should I build into my commercial kitchen plan?
The AIA recommends 10–20% of your total construction and equipment budget as a contingency allowance. For complex renovations of older buildings, budgeting 20% is advisable to cover unforeseen MEP issues. Also maintain a working capital reserve covering 3–6 months of operating expenses to bridge the gap while revenue ramps up.
